Kangaroo Creek Reservoir
A dam in the River Torrens, at Kangaroo Creek, (between Castambul
and Cudlee Creek) was first proposed in 1916, however this weir was never constructed
despite the Gorge Road plan being realigned to allow for it. The Gorge Road construction began in
1912 - 1914 when the section from the Gorge Weir(near Athelstone) to Castambul was
completed, however the section Castambul to the Gumeracha Bridge was not completed until 1924.
In 1962 a submission was made to the Public Works Committee for a much larger dam(Capacity: 24,400
megalitres)to be built at Kangaroo Creek which required a deviation of the Gorge Road to be built
and the construction of two new bridges (Playford Bridge near Castambul
and the New Prairie Bridge near Torrens Hill).
Construction of the Kangaroo Creek dam began in 1966 and was completed in 1969.
The Reservoir was a 24,400 megalitre artificial water storage facility in the Adelaide Hills,
South Australia. It was built by damming the River Torrens west of Cudlee Creek, near its
junction with Kangaroo Creek (hence its name)
.
The dam consists of a 131m long, 65m high concrete clad, rock filled dam wall and the stored water is used to
maintain the Hope Valley Reservoir's level by discharging water into the River Torrens, which then flows into Hope
Valley Reservoir via a pipeline beginning at the Gorge weir, Athelstone.
The water level of Kangaroo Creek Dam can be topped up by water from the River Murray which is discharged from the
Millbrook Reservoir into the River Torrens at Cudlee Creek.
The Kangaroo Creek reservoir was opened by The Hon. R. Steel Hall, M.P., Premier of South Australia, on Friday
5th December 1969.
In 1982, following the River Torrens Flood Mitigation Study(EWS, 1980)
report the dam wall and spillway
were modified to pass a flood with a return period of 50,000 years. The modifications involved raising the height
of the dam and the top of the spillway by 2.75 metres and inserting into the wall of the spillway two outlet ducts
each 4 metres wide by 3 metres high.
Although the height of the dam and spillway were raised, the ducts give a lower overflow level, and storage of
the reservoir was reduced from 24,400 Ml to 19,160 Ml and the overflow frequency increased.
The purpose of Kangaroo Creek reservoir was to increase the storage capacity for River Torrens from 4,500 million
gallons to approx. 10,500 million gallons.
The reservoir area controls 112 sq miles of the River Torrens catchment(which also feeds the
Millbrook Reservoir)and the area of water spread equals 103 hectares.
The Kangaroo Creek Dam submerged 3 Bridges on the old Gorge Road,:-
Batchelor's Bridge (located just behind the dam wall),
Crouch's Bridge (located further east, between the dam wall and Torrens Hill),
and Prairie Bridge (located still further east, just below Torrens Hill).
THE KANGAROO CREEK DAM UPGRADE (2015 - 2019)
All photos © Bill Chartres unless otherwise acknowledged.
Kangaroo Creek Dam Upgrade
During 2015-2019 SA Water upgraded the Kangaroo Creek Dam.
Kangaroo Creek Dam is a concrete face rockfill dam with a side channel spillway; it is located
on the River Torrens (near Castambul) about 22km north east of Adelaide, South Australia, and
was originally constructed between 1966-69 to provide additional storage for Adelaide’s
metropolitan water supply.
The upgrade ensured that the dam complied with ANCOLD (Australian National Committee on Large Dams)
standards.
Construction began in late 2015, and was completed by November 2019.
The work widened the spillway, raised the wall and strengthened the wall embankment.
The upgrades will also help manage major floods and increase the dam's ability to withstand earthquakes.
However it does not increase the dam’s capacity, as the spillway height
remains unchanged.
SA Water plans minor revegetation for the site in April 2020, which will include hydroseeding
of the location of the construction site compound.
Contractor Bardavcol Pty Ltd
Contract Value $78,513,994
Completion Date September 2018
Project Description
Major safety upgrade to the existing concrete lined rock fill dam to meet ANCOLD requirements
Excavation of 300,000m3 of rock to widen the spillway by up to 40m
Extension of the outlet tunnel and pipe work by approximately 50m
Buttressing of the existing rock fill embankment (200,000m3)
Raising of the embankment crest including extension of the concrete face slab using slip form
techniques
Significant concrete works (32,000m3) to line the spillway including temperature sensitive mass
pours and ogee crest construction
Construction of post tensioned anchors to the existing ogee crest
Electrical, SCADA and security works
The final cost of the upgrade was $94 million. Source SA Water

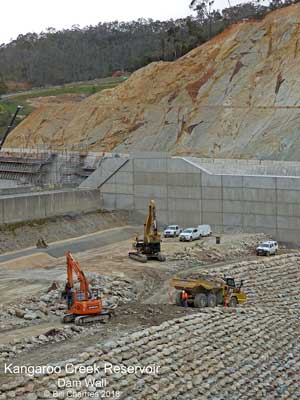

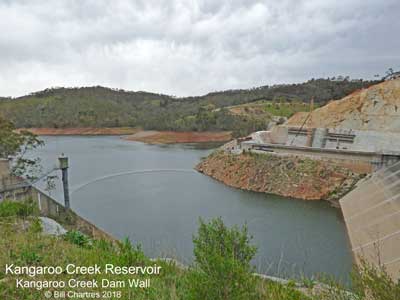

Kangaroo Creek Dam Spillway - August 2018
The Spillway is being widened by 40 metres.
(Photo (©) - Peg & Bill Chartres' collection - circa
2018)
Kangaroo Creek Dam Spillway - September 2010
During the upgrade the Spillway will be widened by 40 metres.
(Photo (©) - Peg & Bill Chartres' collection - circa
2010)
Kangaroo Creek Dam Spillway - August 2018
The Spillway is being widened by 40 metres.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Strengthening of embankment downstream of the dam wall
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Dam Wall and Spillway
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Wall and Spillway
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Wall and Spillway
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Wall
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Wall and Spillway
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Spillway
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Wall and Spillway
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Reservoir
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Wall Embankment
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Wall Embankment
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Wall Embankment
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Spillway
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Embankment
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Embankment
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Wall
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam Spillway
September 2018
(Photo (©) - Peg & Bill Chartres' collection - September
2018)
Kangaroo Creek Dam
20
th May 2018
Working on the widening of the spillway.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Dam embankment - 20
th May 2018
Working on the widening of the spillway.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Dam embankment - 20
th May 2018
Working on the widening of the spillway.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Dam Spillway - August 2018
The Spillway is being widened by 40 metres.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Strengthening of embankment downstream
of the dam wall.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Dam - 20
th March 2018
Rock material from next to spillway used to strengthen
the existing embankment downstream of the dam wall.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - August 2018.
Batchelor's Bridge is completely submerged once again.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Dam - 20
th May 2018
The embankment strengthened.
(Photo (©) - Peg & Bill Chartres' collection - circa
2018)
Kangaroo Creek Dam Spillway - August 2018
The Spillway is being widened by 40 metres.
(Photo (©) - Peg & Bill Chartres' collection - circa
2018)
Kangaroo Creek Dam - May 2017
Widening of the Spillway continues.
(Photo (©) - Peg & Bill Chartres' collection - circa
2017)
Kangaroo Creek Dam - August 2019
(Photo (©) - Peg & Bill Chartres' collection - circa
2019)
Kangaroo Creek Dam Spillway - August 2019
(Photo (©) - Peg & Bill Chartres' collection - circa
2019)
Kangaroo Creek Dam Spillway - August 2019
.
(Photo (©) - Peg & Bill Chartres' collection - circa
2019)
Kangaroo Creek Dam Embankment and Spillway - August 2019
(Photo (©) - Peg & Bill Chartres' collection - circa
2019)
Dam wall - August 2019
(Photo (©) - Peg & Bill Chartres' collection - circa
2019)
Kangaroo Creek Dam Wall - August 2019
(Photo (©) - Peg & Bill Chartres' collection - circa
2019)
Kangaroo Creek Dam Wall - August 2019
.
(Photo (©) - Peg & Bill Chartres' collection - circa
2019)
Kangaroo Creek Dam Wall - August 2019
(Photo (©) - Peg & Bill Chartres' collection - circa
2019)
Kangaroo Creek Dam - August 2019
(Photo (©) - Peg & Bill Chartres' collection - circa
2019)
Kangaroo Creek Dam
Upgrade completed December 2019
(Photo SA Water - Peg & Bill Chartres' collection - circa
2020)
Photos the Old Gorge Road and the [normally] submerged section of the River Torrens.
Kangaroo Creek Reservoir - September 2018
Ruins of the original Prairie Bridge
destroyed by a flood in the 1990's
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Old Prairie Road near the junction with Old Gorge Road
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Old Gorge Road - September 2018
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Old Gorge Road near the new Prairie Bridge.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Crouch's Bridge.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Crouch's Bridge.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Old Gorge Road approaching The Cantilever.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Old Gorge Road just west of The Cantilever
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
The Cantilever
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Old Gorge Road
Dry stone wall embankment stays intact
despite land slip
Just west of The Cantilever.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
The hills forming the boundary of the reservoir
are bare, with the topsoil having been washed down
to silt up the valley
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
As the River Torrens is slowly filling
the reservoir, it is cutting a new path
through the silt as it continues on its way
towards the level of the reservoir
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
The River Torrens continues its journey
until it finally becomes
The Kangaroo Creek Reservoir.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Batchelor's Bridge is dwarfed by the Dam Wall
as it slowly returns to its watery grave.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Kangaroo Creek Reservoir
near Batchelors Bridge.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Batchelor's Bridge
and the Dam Wall
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Batchelor's Bridge
slowly returns to its watery grave.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
River Torrens, below the New Prairie Bridge.
This section of the river is about the level of the reservoir when 100% full
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
River Torrens, below the New Prairie Bridge.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
River Torrens, below the New Prairie Bridge..
The green area shows the hight of the reservoir when 100% full
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Old Gorge Road below the new Prairie Bridge.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Photos of Batchelor's Bridge.
Kangaroo Creek Reservoir - March 2018
Batchelor's Bridge exposed during the dam wall upgrade.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - March 2018
Batchelor's Bridge exposed during the dam wall upgrade.
(Photo (©) - Peg & Bill Chartres' collection - circa 2010)
Kangaroo Creek Reservoir - March 2018
Batchelor's Bridge exposed during the dam wall upgrade.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
Kangaroo Creek Reservoir - September 2018
Batchelor's Bridge now completely covered.
(Photo (©) - Peg & Bill Chartres' collection - circa 2018)
More photos and information can be seen here
A walk along the old Gorge Road
